Drywall Estimating Services

Board, ceilings and finishing counted by wall type. Order drywall only, or add metal studs, insulation or ACT.

Get a Fixed Quote   See a Real Sample

Drywall estimating services turn your drawings into a material list you can price and order. We count the board, ceilings and finishing for every wall type. You pick the scope, and we quote it as a fixed fee.

2–4 hrsto a fixed quote (business hours)
24–48 hrsmost takeoffs
$150starting fee

What Drywall Estimating Services Do We Offer?

Six ways to order. Scopes ordered together are measured once, from the same wall types, so their quantities agree.

You orderWhat we count
Drywall onlyBoard, ceilings, soffits, pre-rock, shaft liner, finishing by level, trims, screws and sealantsQuote this
Drywall + metal studsDrywall only, plus studs, track, shaft wall framing, furring and ceiling framingQuote this
Drywall + insulationDrywall only, plus thermal and sound insulationQuote this
Full interior packageFraming, drywall and insulation togetherQuote this
Add-on: ACT ceilingsGrid, tile and hanger wire by ceiling typeQuote this
GC scope checkIndependent quantities to level drywall and framing bidsQuote this

What's Included in a Drywall Takeoff?

Walls by Wall Type

  • Board by type and thickness: regular, Type X, Type C, moisture-, mold- and abuse-resistant
  • Each layer on each side listed on its own line, so double-layer walls aren't averaged
  • MR board and tile backer split out to the heights the details show
  • Sheet lengths that fit your wall heights (8' to 12', 54" board where specified)

Ceilings and Soffits

  • Gypsum ceilings by assembly and height, from the reflected ceiling plans
  • Rated ceilings layer by layer, each with its own screws
  • Soffits, bulkheads and box beams by detail, in LF and SF

Pre-Rock and Shaft Walls

  • Pre-rock where rated walls must be boarded before tubs, trusses or chases close them in
  • Shaft liner at shafts and stair enclosures (studs are in the framing takeoff); see the multifamily case study for pre-rock carried as its own delivery
  • Backing and blocking where the drawings detail it

Finishing and Trims

  • Finish level per area, Level 1 through Level 5 (see the finish levels guide)
  • Tape, taping compound and topping compound in rolls and gallons
  • Corner bead, J and L bead, control joints and reveals

Fasteners and Sealants

  • Screws by length and type for each layer
  • Acoustical sealant at the head and base of rated and sound walls, in LF
  • Sealant at tubs, showers and window returns, as drywall consumables

Drywall Board Types We Count

Each board type is its own line, because each is priced and ordered on its own.

BoardCommon thicknessWhere it goes
Regular gypsum board1/2"Non-rated walls and ceilings
Type X5/8"Fire-rated walls and ceilings
Type C1/2", 5/8"Rated ceilings and floor-ceiling assemblies
Moisture- and mold-resistant1/2", 5/8"Baths, kitchens and wet walls
Abuse- and impact-resistant5/8"Corridors, schools and healthcare
Shaft liner1"Shaft and stair walls, with C-H or CT studs
Tile backer or cement board1/2"Showers and tub surrounds
54" wide board1/2", 5/8"9' walls with one less seam

Finish Levels in a Drywall Takeoff

Finishing is counted by level, area by area. Pricing a whole job at Level 4 misses both ends.

LevelWhat it isTypical use
Level 0Board hung, no finishTemporary work
Level 1Tape embedded in compoundAbove ceilings, shafts, fire taping
Level 2Tape embedded and wiped thin; fasteners coveredGarages, behind tile
Level 3Two coatsHeavy texture
Level 4Three coats at jointsFlat paint, light texture
Level 5Level 4 plus a full skim coatGloss paint, critical lighting

More detail in the finish levels guide.

How Do We Estimate Drywall?

We read the drawings in the order an estimator should. Wall types come first; quantities come last.

  1. Wall types first. Each partition type is set up with its layers, ratings and heights.
  2. Walls by type. Each wall is traced on the plans and tagged to its type and height.
  3. Ceilings from the RCPs. Areas by assembly and height. Soffits and bulkheads from the details.
  4. Finishes and specs. Finish levels come from the finish schedule. Board products come from the specs.
  5. Gaps flagged. A missing wall type or ceiling height is listed with the assumption we used.
  6. Order units. SF becomes sheets. LF becomes rolls and pieces. Waste sits on its own line.

Worked Example: One Delivered Wall

This exterior wall comes from the multifamily sample, drywall lines only. The last column shows the math behind each line.

Line in the delivered takeoffQtyUnitHow it's figured
Wall length with 5% waste579LF551 LF × 1.05 = 578.55
5/8" Type X board, 1 layer, 1 side6,173SF578.55 LF × 10.67 ft high
4'x12' Type X sheets129Sheets6,173 ÷ 48 SF = 128.6, rounded up
500' tape rolls9RollsAbout 1 roll per 690 SF
Joint compound31GallonsAbout 1 gallon per 200 SF
1-1/4" drywall screws33PoundsAbout 1 pound per 4 sheets

Your ratios will change with sheet size, finish level and layout. That's why we count each wall instead of using a rule of thumb.

Common Drywall Takeoff Mistakes

These are the misses we see most when we check other takeoffs. Each one costs money at buyout.

  • Averaged layers. Each layer on each side of a wall is its own line.
  • Hidden layers left out. Party walls and rated chases often hide a layer behind tubs or shafts.
  • One sheet length for every wall. Wall height sets the sheet length, and that sets seams and waste.
  • One finish level for the whole job. Tile areas need Level 2; gloss paint needs Level 5.
  • Missing soffits and bulkheads. They live on the details, not the floor plan.
  • No sealant. Rated and sound walls need it at the head and base.
  • One waste factor for everything. Board, framing and finishing waste differ (see the waste factor guide).

What You Get Back

  • A takeoff spreadsheet by wall type and ceiling area, with a drawing reference on every line
  • A material list in order units, with the SF or LF each line covers
  • Color-coded markups of your plans, so every number can be checked
  • A list of assumptions and drawing gaps
  • Excel, PDF or CSV, with free revisions within 48 hours

Which Projects Do We Estimate?

Multifamily and Townhomes

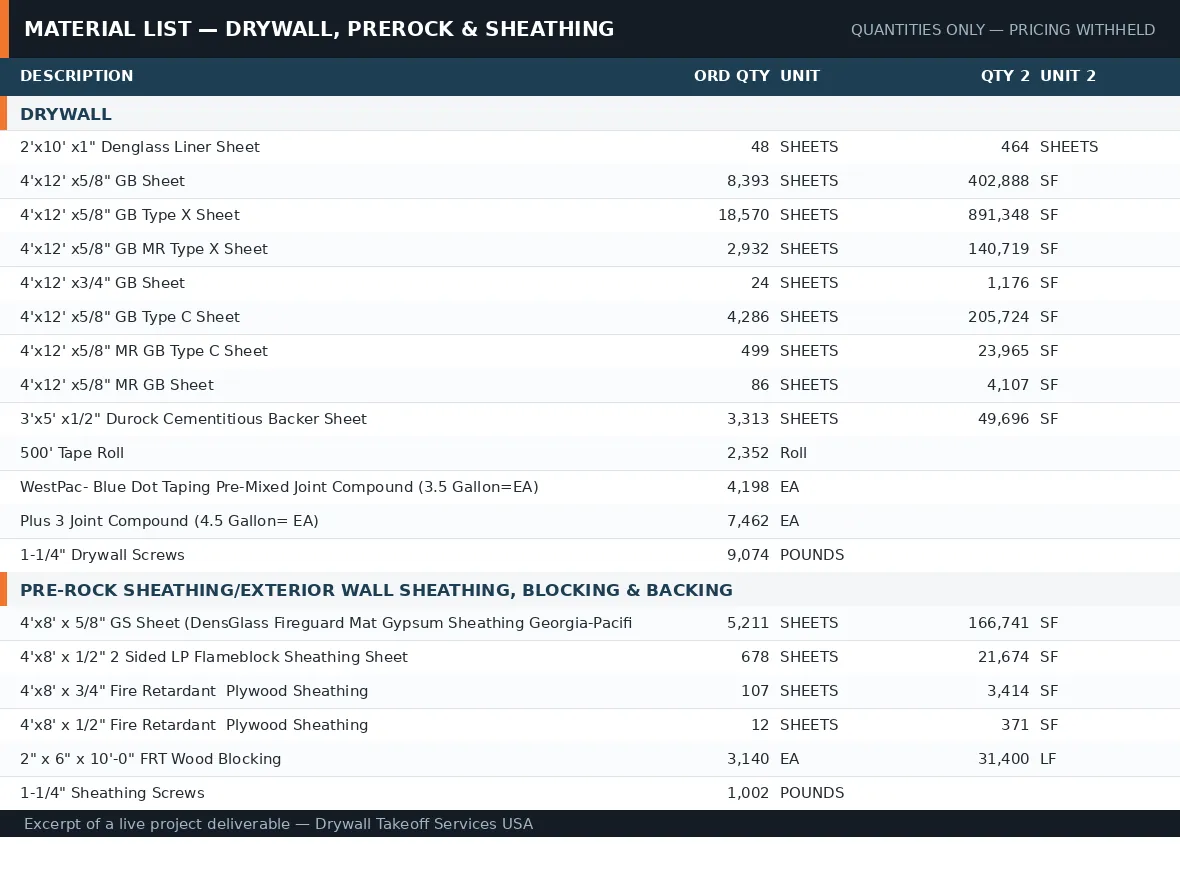

We build the takeoff per unit type and condition, then multiply by the unit count. Rated corridor and demising walls stay on their own lines. See the 122-unit multifamily case study: 3,056 lines in 16 deliveries, including pre-rock.

Single-Family and Remodels

Usually drywall only: board by room and height, garage separation, MR board and tile backer. Starting from $150 per project.

Commercial, Healthcare and Schools

More wall types, more rated assemblies and more ceiling work. The healthcare sample covers 92 wall conditions.

Hotels, TI and Retail

Hotels repeat room types like multifamily. Tenant improvements are smaller but detail-heavy, and often due fast. The medical office TI case study shows one: FRP, cement board, texture to match existing and patch and repair.

Drywall Scope Checks for GCs

General contractors order the same takeoff as an independent baseline. Compare drywall and framing bids line by line. See which sub left out a scope. Answer change orders with measured numbers.

How Much Do Drywall Estimating Services Cost?

Drywall estimating starts from $150 per project.

Every quote is a fixed fee for the scopes you tick, sent within 2–4 business hours. It's agreed before any work starts.

ProjectFixed feeTypical delivery
Single-family, remodelStarting from $150 per project24–48 hours
Tenant improvement, commercial to ~12,000 SFStarting from $300 per project24–48 hours for most TI; 3–5 business days for full sets
Multifamily, larger commercialQuoted per project3–5 business days; large sets confirmed with your quote
Rush+30%Scheduled to your bid date

How Long Does a Drywall Estimate Take?

Most residential and tenant-improvement takeoffs take 24–48 hours. Full commercial and multifamily sets take 3–5 business days. Rush is 30% extra and is scheduled to your bid date.

What Files Do You Need?

PDF drawings are enough. DWG, DXF and RVT work too. For a drywall takeoff, send:

  • Floor plans and the wall type (partition) schedule
  • Reflected ceiling plans and ceiling details
  • The finish schedule
  • Details for rated walls and ceilings, and the specs if you have them

Upload the files with the form below or paste a link. Partial sets are fine; we tell you what's missing before we start.

Drywall Takeoff vs Drywall Estimate

A takeoff is the quantities: sheets, studs, tape and compound. An estimate adds material prices and labor. We deliver the quantities. You apply your own prices and labor rates, so your number stays yours.

Drywall Estimating Services FAQs

Can I order drywall estimating without metal studs or insulation?

Yes. Drywall only is the most basic order: board, ceilings, finishing, trims, screws and sealants. Framing, insulation and ACT are added only if you tick them.

What does a drywall estimating service include?

Board by type, thickness and layer for every wall and ceiling. Soffits, pre-rock and shaft liner. Finishing by level, trims, screws and sealants. You get a takeoff, a material list and marked-up plans.

How much does drywall estimating cost?

Starting from $150 per project for single-family and from $300 per project for commercial up to about 12,000 SF. Multifamily is quoted per project. Every quote is a fixed fee.

How long does a drywall estimate take?

Most residential and tenant-improvement takeoffs take 24-48 hours. Full commercial and multifamily sets take 3-5 business days. Rush is available.

How many sheets of drywall do I need?

Divide the board area, with waste, by the sheet area and round up. A 4x12 sheet covers 48 SF, so 6,173 SF needs 129 sheets. Count each layer and each side separately.

Are sealants included in a drywall takeoff?

Yes. Acoustical sealant at rated and sound walls, and sealant at tubs, showers and window returns, are listed in LF as drywall consumables.

Do you take off acoustical ceilings (ACT)?

Yes, as an add-on. Grid, tile, wall angle and hanger wire by ceiling type. Order ACT with the drywall takeoff or on its own.

Can I see a real drywall takeoff before I order?

Yes. Four takeoffs are published as PDFs on the sample page, and two of them are written up as case studies: a 122-unit multifamily building in Massachusetts and a medical clinic TI in Idaho. Prices are removed; quantities are as delivered.

Get a Drywall Estimating Quote

Tick your scope and send plans or a link. You get a fixed fee and a delivery date within 2–4 business hours.

Start Your Quote

Fixed price for the scope you tick, back within 2–4 business hours.

What are you bidding? * tick all that apply
Your plans upload, paste a link, or email them later

Prefer email? Send plans to info@drywalltakeoffservices.com. Drawings stay confidential; NDA on request.

Bid Due Soon? Send Your Plans.

Fixed quote in 2-4 business hours. Most takeoffs in 24-48. Free revisions within 48 hours.

Upload Your Plans
Bid date coming up? Fixed quote in 2–4 business hours • most takeoffs in 24–48.
Upload Plans
Sam — DT Estimating Team
Drywall Takeoff Services USA
Online now
DT
Hi! I'm Sam from the DT estimating team. I can answer questions about our drywall takeoff services, pricing, turnaround, process — or help get a quote started right now.
Have Questions? Ask Us
Your email and what you're bidding — then chat instantly
We'll also follow up with a free quote if you share your project. No spam, ever.
🔒 Your email is only used to follow up — never shared or sold
Drywall Takeoff Services USA · drywalltakeoffservices.com · +1 (332) 242-5480
